Construction Enquirer: Race starts for £30m mega container store at London Gateway
The latest construction enquirer focus at London Gateway is not just about another port project. It is about how a live terminal, a 12-storey automated storage building and a tight procurement timeline are being pulled into one package. Contractors are now lining up for a £30m high-tech container storage shed that combines deep foundations, major steelwork and complex logistics. The scale is unusual, but so is the setting: a fully operational dock where every sequence, access route and safety decision will matter.
Why the London Gateway scheme matters now

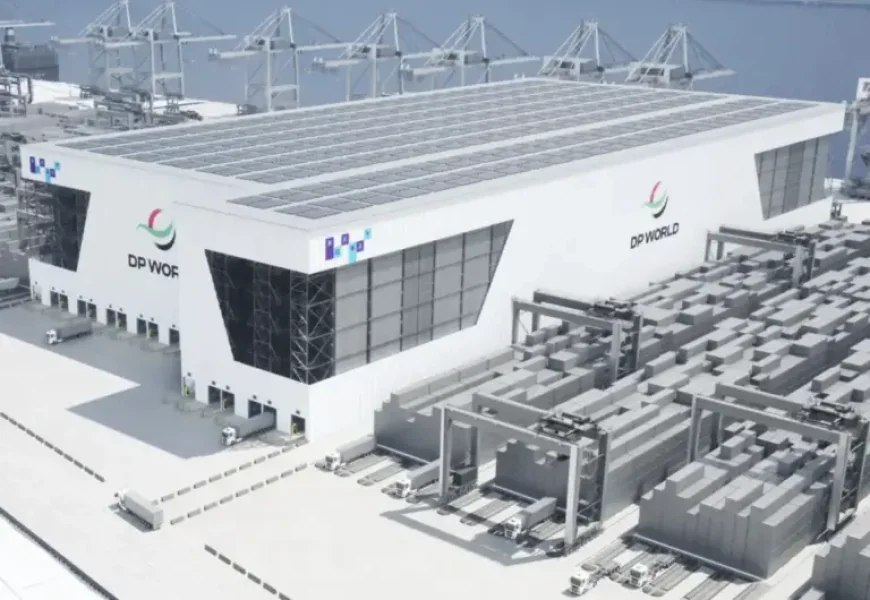

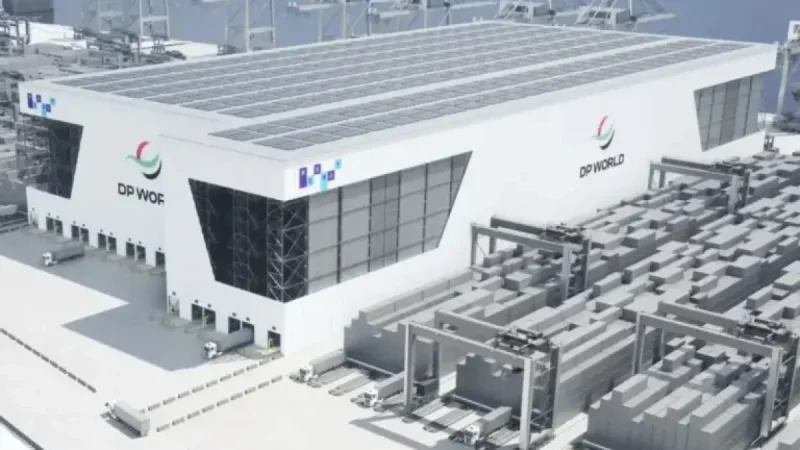

London Gateway Port has invited bids for a next-generation BOXBAY storage scheme at the Thurrock terminal. The plan is for a 12-storey automated empty container stacking facility that will rise to around 55m, stretching 323m long and 159m wide across the existing MT Park area. That makes the project a major piece of port infrastructure, not a simple warehouse build. For the construction enquirer audience, the significance lies in the blend of height, automation and operational pressure, all within one contract.
The procurement route underlines the urgency. Contractors must first enter a selection stage before shortlisted bidders are invited to tender and negotiate. Final bids will be judged on a 60: 40 price-to-quality split, with contract award expected in July and the two-year build due to start on site later that month. Requests to participate must be submitted by 29 April. That timetable leaves little room for drift, especially with the scheme still at the pre-award stage.
Deep analysis: what lies beneath the headline
The most striking feature is the engineering mix. The job combines heavy civils, deep foundations and a structural steel package of more than 15, 000 tonnes. It also calls for 50, 000m² of cladding and a 46, 500m² roof. On the ground, the contractor will need to deliver over 5, 000 precast piles, each around 28m long, supporting a 1. 2m deep reinforced concrete raft. That combination points to a build where structural load, ground support and enclosure work are all tightly linked.
Infrastructure scope adds another layer of complexity. The selected contractor will be responsible for drainage, power, firewater and IT systems, as well as heavy-duty pavements and ancillary buildings. The structure itself will house 15 automated storage retrieval machines running on 3km of rail, while the systems will be supplied separately. That separation matters: it means the building and enabling works must be precise enough to support equipment installation later, without creating interface problems during handover.
The most difficult constraint is the live port environment. Work will take place within an operational terminal, which demands careful sequencing, logistics management and safety controls. In practical terms, the contractor will need to build around moving port activity rather than clearing a site and starting from a blank canvas. That is often where major infrastructure projects become most vulnerable to delay, because access, storage, deliveries and temporary works all compete for space.
Expert perspectives and procurement signals
Procurement structure can tell as much as the technical brief. A competitive flexible procedure suggests the client wants both early market engagement and room to refine the solution before award. In a project of this type, that usually reflects the need to test buildability, staging and interface management before locking in the final package. The 60: 40 price-to-quality weighting also signals that cost will matter, but not at the expense of technical delivery in a constrained working port.
The project brief itself makes the engineering priorities clear. The heavy steel tonnage, the deep piles, the raft foundation and the integration of power, firewater and IT systems all point to a build that will be judged on coordination as much as on raw output. For firms considering the bid, the challenge is not only constructing the shed, but proving they can do it safely and efficiently while the terminal remains active.
From an analytical perspective, the scheme also reflects a broader operational logic. The 15-storey-style automation model is designed to concentrate storage vertically rather than spreading it horizontally across scarce dockside land. That is a significant response to space pressure in a busy terminal setting, and it explains why the project is being treated as a high-value, technically demanding package rather than a standard storage facility.
Regional and wider impact on port infrastructure
For the Thames-side logistics corridor, the scheme matters because it shows how port operators are using construction to solve capacity and land-use problems at the same time. A structure of this scale will influence not just how containers are stored, but how space is managed across the yard. The project’s size and design may also affect how future automated port facilities are packaged for delivery, especially where live operations limit construction freedom.
For contractors, the message is equally clear. The market for complex port civils remains active, but success will depend on technical discipline, phasing and risk control. The construction enquirer angle here is not simply the price tag; it is the way procurement, engineering and live-terminal logistics have been locked together around one deadline. If the July award holds and the two-year build begins as planned, the next question is whether the industry can deliver automation infrastructure at this scale without disrupting the port it is meant to strengthen.
